Datan Combined Cycle Power Plant Expansion Project

Project Description

Background

Respond to the growth of domestic power consumption, Taiwan Power Company (TPC) follows the government’s energy policy and promotes the " Datan Combined Cycle Power Plant Expansion Project" to ensure stable power supply. TPC plans to add three high-efficiency gas-fired combined cycle units at current plant site, with the total capacity of 3160MW.

In 2016, owing to the changes in the existing and the newly added power units, which could have directly led to power shortages in 2017-2019, emergency generator units were needed to be added. Based on the comprehensive assessment results of Site conditions, TPC initiated the Datan Emergency Gas Turbine Generator Project at Datan Power Plant site to relieve the tension of electric supply. The all-turkey was contracted by GE to install two gas-fired simple cycle units with a total installed capacity of 600MW..



Project Location and Scope

The Datan Power Plant (DTPP) is located at the Datan coastal industrial park, Guanyin District, Taoyuan City, with a length of about 2,300 m and a width of about 750 m. The total area is about 116.02 hectares. There are six combined cycle units in operation, totally 4386 MW. The project "Datan Combined Cycle Power Plant Expansion Project" will install 3 combined cycle units at the south vacant lot of DTPP approximately 19.8 hectares. Besides, TPC has completed the installation of two phase 1 gas-fired simple cycle units (300 MW per unit) at the unit 7 site with a total installed capacity of 600 MW.

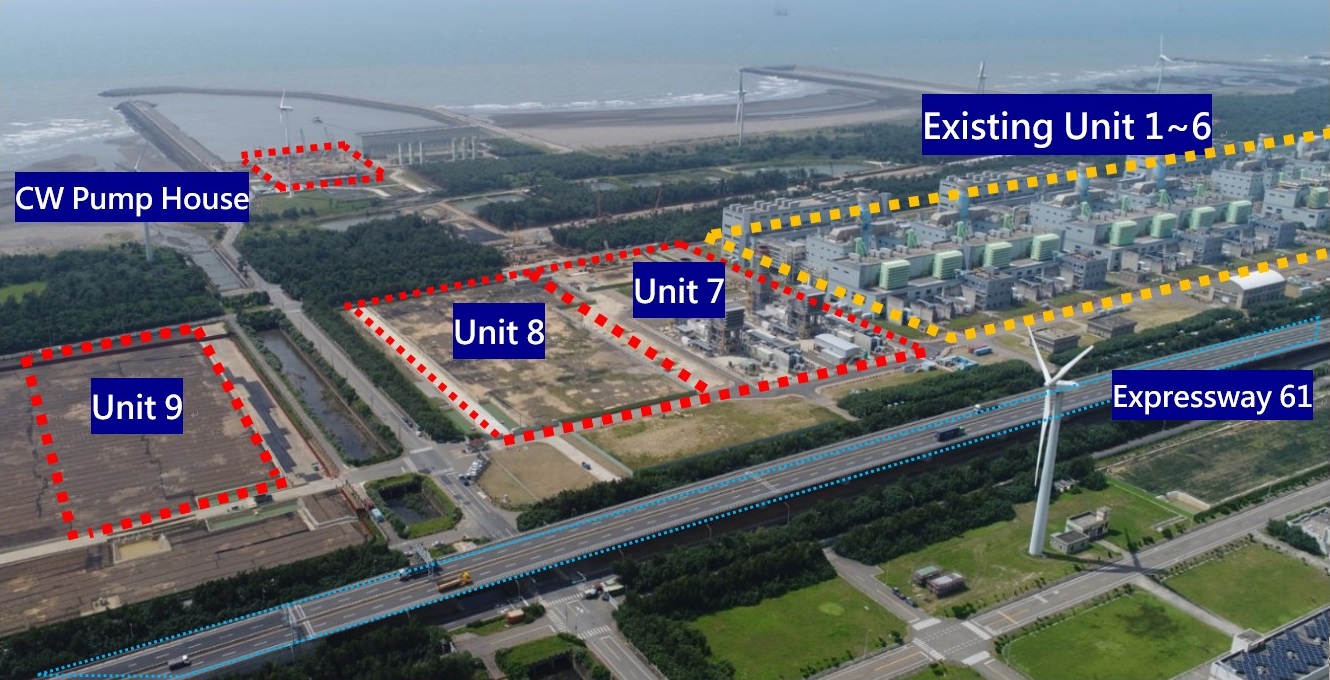

Unit 7 Simple Cycle Units (300 MW per unit)
Unit 7 Simple Cycle Units (300 MW per unit)

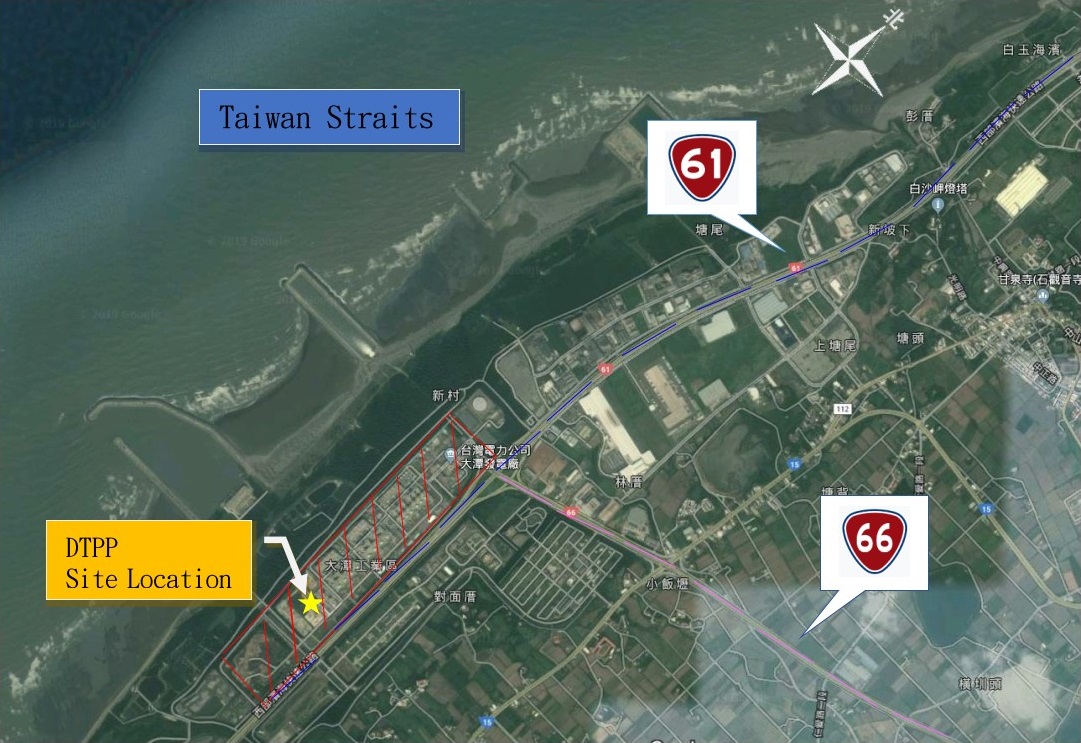

Location and Traffic of DTPP
Location and Traffic of DTPP

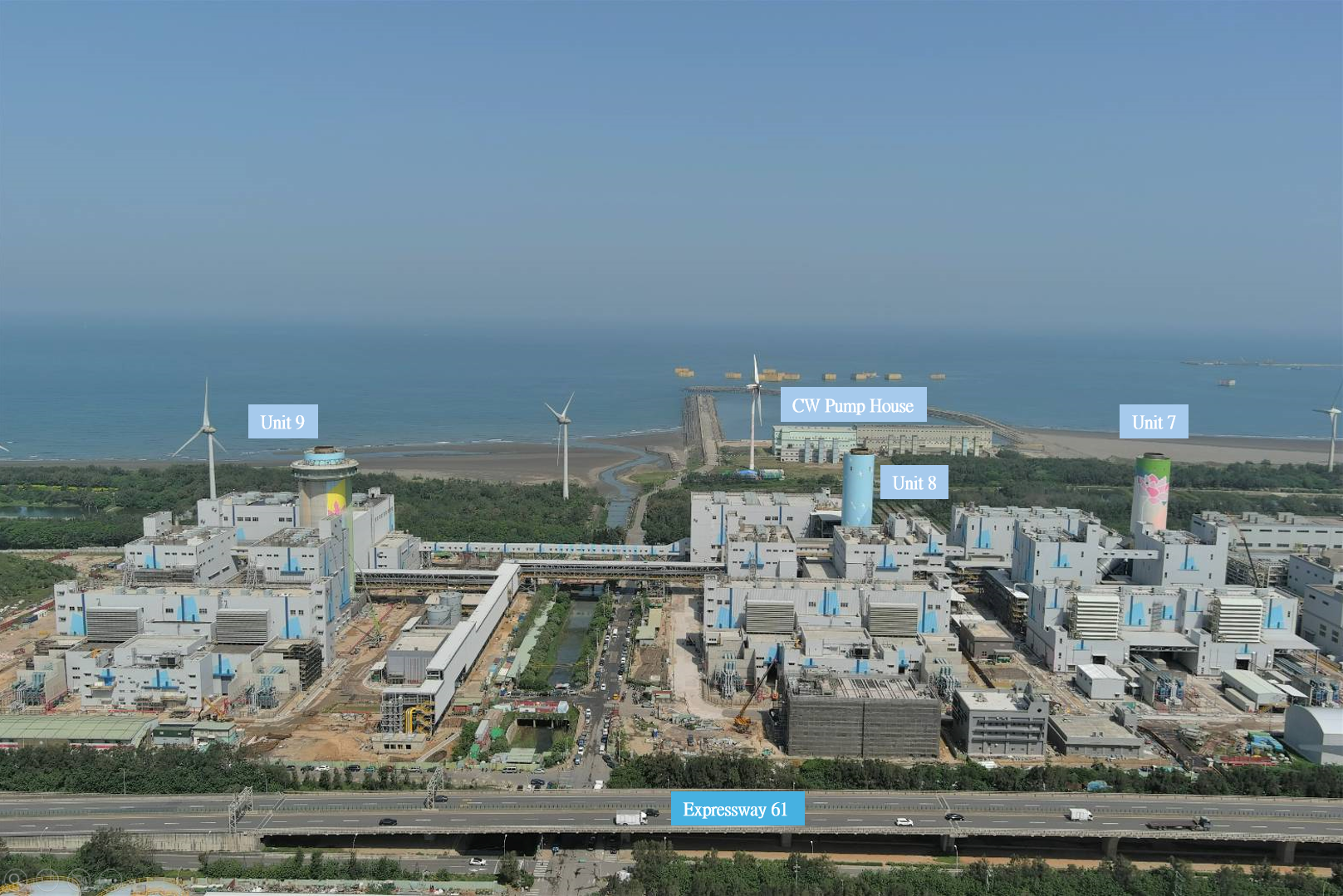

DTPP Expansion Project Plant Arrangement
DTPP Expansion Project Plant Arrangement



New Design Units Specification

Item Specification
No. of Unit 3 (Units 7, 8, 9)
Installed Unit Capacity Units 8 & 9: 2247 MW
Unit 7: 913 MW
Unit Type Combined Cycle Units (2on1)
Net Thermal Efficiency Above 60.7% (LHV)
Net Heat Rate Below 5,930kJ / kWh (LHV)
Gas turbine In-Door/ For Power Generation /3,600 rpm
Heat Recovery Steam Generator In-Door / Horizontal Gas Flow Type
Steam Turbine In-Door /3,600 rpm
Generator Hydrogen-Cooled / Three-phase Synchronous Machines / 3600 rpm
Transformer Outdoor Type Oil-immersed / Three-phase / 60 Hz



Progress Status

Project Progress

Overall progress(%) (April-2026)
Schedule Actual Difference
99.98 99.98 0

Commercial Operation Date (COD)/
Obtaining Electricity Generation license
Unit 7 (Phase II) Unit 8 Unit 9
2026/1/12 2024/7/31 2025/7/23
Note:
  1. The Second Revision of the Datan Combined Cycle Power Plant Expansion Project was approved by the Executive Yuan's letter No. 1151006001 on March 25, 2026.



Construction Status:

All three Units have obtained Electricity Generation License and are in commercial operation.

Environmental Protection Planning
  1. Selective Catalytic Reduction System (SCR) used for environmental protection.

    Pollutant Emission Concentration
    SOx 10 ppm
    NOx 5 ppm
    Particulate 10 mg/Nm3
